Hot Tapping Operation at B193, 28 Hours from shore

Updated on: February 24, 2025
Category:
Offshore

Tritorc secured a challenging offshore hot tapping project from one of the largest MNCs in the world through a strategic and collaborative approach. Leveraging strong industry reputation and expertise in hot tapping solutions, Tritorc engaged proactively with the client’s procurement and engineering team.

Introduction:

The hot tapping project at an offshore process platform aimed to create a new 8-inch connection on an existing 12-inch pipeline to facilitate process expansion. This execution was carried out in the 1st and 2nd week of April 2024. The need for the hot tapping project arose from the client’s requirement to expand their process capabilities while ensuring minimal disruption to ongoing operations. The platform, located in the Northern oil field in the Indian Ocean, required a reliable and efficient solution to accommodate the expansion.

Project Objectives:

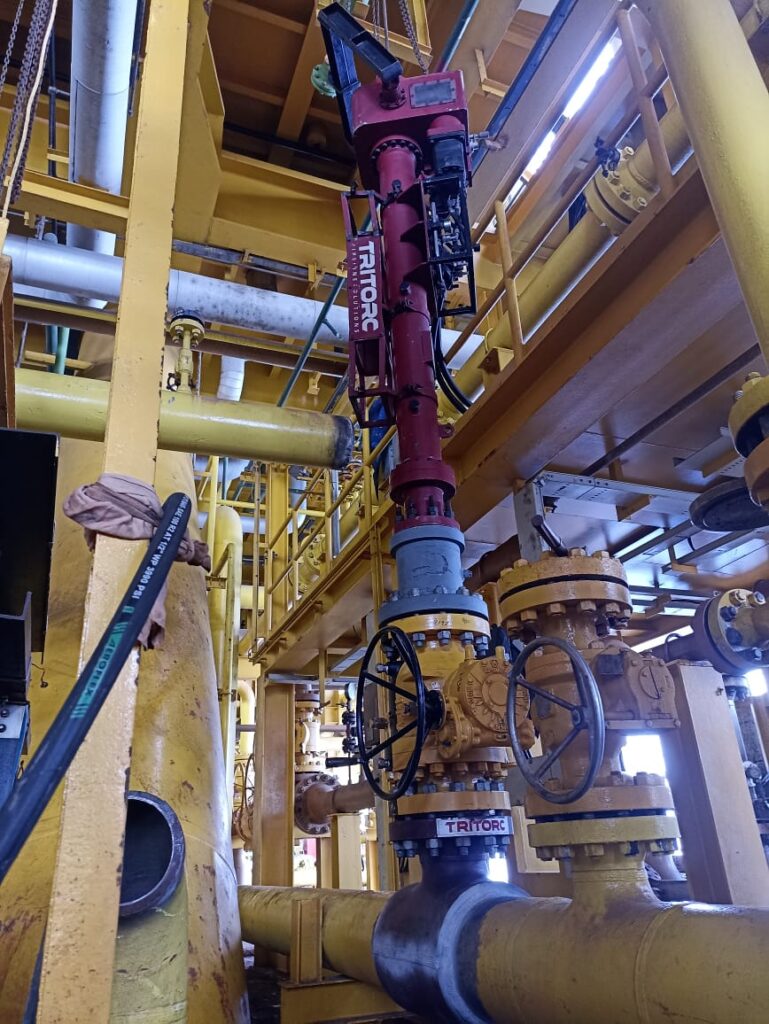

WhatsApp Image 2024 04 14 at 1.55.48 PM 1 2

The project involved meticulous planning, including site selection, safety assessments, and equipment procurement. Tritorc deployed specialized hot tapping equipment modified for H2S environments.Exposure to H2S poses significant environment and safety concerns. Given the presence of corrosive gas, Tritorc addressed environmental concerns by implementing ventilation systems, providing appropriate personal protective equipment, conducting risk assessments, monitoring H2S levels, and complying with environmental regulations. The hot tapping procedure followed industry standards and incorporated innovative techniques to ensure precision and safety.

Quality Control checks and Inspections:

1. Before the mobilization of the split tee, all non-destructive testing (NDT) tests were carried out as per the ASME Section V standards to ensure the integrity of the equipment and materials.

2. During the split tee welding process, dye penetrant testing (DPT) was conducted for root welding, and all subsequent passes underwent magnetic particle inspection (MPI) to detect any potential defects or imperfections in the welds.

3. Additionally, a function leak test was performed according to API 2201 standards before the hot tapping process to verify the integrity of the connections and to ensure there were no leaks present before proceeding further with the operation. These checks and inspections help maintain high-quality standards and ensure the safety and reliability of the equipment and operations.

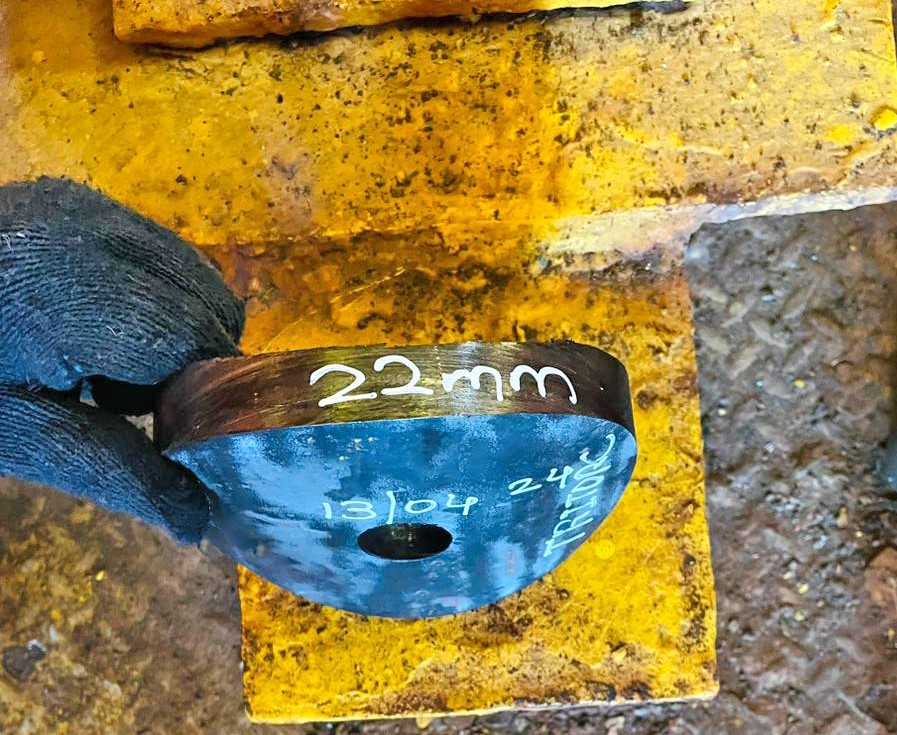

Hot Tapping ONGC 005

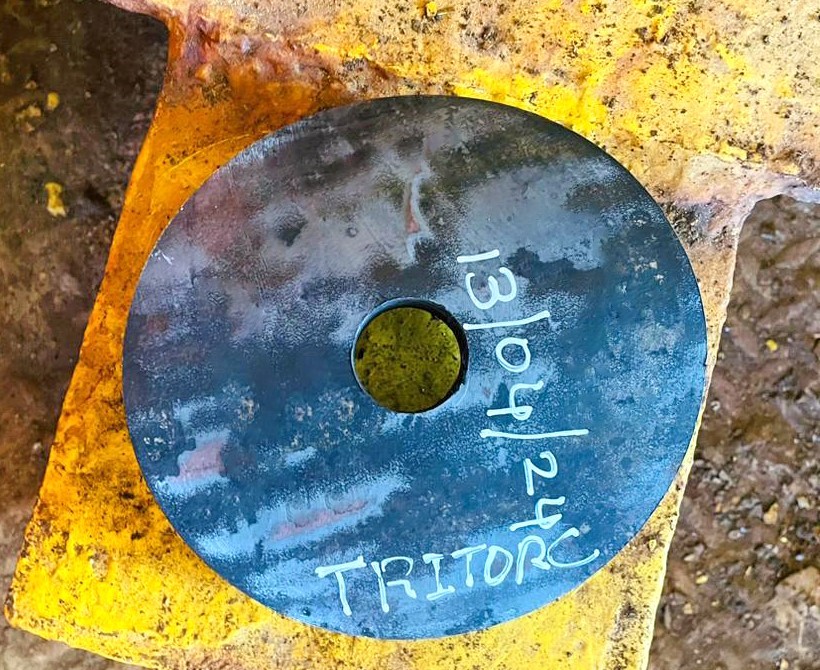

0002

Challenges Faced and Solutions Implemented:

Challenges such as equipment availability, suitability, and offshore logistics were addressed through careful planning and collaboration with suppliers. The team implemented innovative approaches, including pressure-balancing hot tapping machines and inconel fasteners, to overcome operational constraints. Heavy tools and equipment for hot tapping were transported to the offshore site via supply vessels.

WhatsApp Image 2024 04 14 at 1.55.49 PM 1 2 1

Results and Outcomes:

The hot tapping operation was executed successfully, achieving all project objectives. Quality control checks and inspections were conducted throughout the process to maintain high standards. The operation was completed within the scheduled timeline and budget, demonstrating expertise and efficiency.

WhatsApp Image 2024 04 14 at 1.55.48 PM 4

Key Takeaways:

Key takeaways from the project include the importance of specialized equipment, rigorous safety protocols, and continuous quality control. Recommendations for future projects include the use of advanced cutting tools, pressure-balancing machines, and high-quality fasteners to enhance efficiency and reliability.

Conclusion:

The hot tapping project at the offshore Process Platform showcased Tritorc’s commitment to delivering innovative solutions while prioritizing safety and quality. The successful execution of the operation underscored Tritorc’s expertise in hot tapping technologies and its ability to meet client needs in challenging environments.

Related Blogs
  • Tritorc in Uzbekistan

    Tritorc’s Retubing Maintenance Project in Uzbekistan: A Comprehensive Case Study

    In a landmark project showcasing technical prowess and industry-leading capabilities, Tritorc has successfully completed a crucial heat exchanger retubing and maintenance operation in Uzbekistan’s oil and gas sector. This project, focusing on oxygen preheaters, highlights Tritorc’s position as a complete solution provider for heat transfer equipment maintenance in challenging environments.  Tritorc’s engineers demonstrated their versatility […]
    March 28, 2025
    Simran Avatar
  • NCOC Karabatan Tritorc

    Engineering Excellence in High-Pressure Onshore Operations: The Karabatan NCOC Project

    Kazakhstan’s Karabatan Onshore Processing Facility, part of the North Caspian Project, exemplifies cutting-edge engineering in one of the world’s most challenging onshore environments.  Developed under the North Caspian Production Sharing Agreement (NCPSA), this facility processes hydrocarbons from the Kashagan field, one of the largest oil discoveries in recent decades. The project holds an estimated 9–13 […]
    March 18, 2025
    Puneet Avatar
  • oil-gas-industry

    The Future of Oil and Gas Maintenance—How Tritorc is helping solve Critical Challenges

    Oil and gas is at a crossroad right now because of the growing demand, new technology, and the environmental pressures that will eventually change the face of operations. One of the biggest issues is still that of effective maintenance, specifically the avoidance of forced outages, the extension of asset life, and the upholding of high […]
    March 28, 2025
    Puneet Avatar
  • Retubing-application

    Retubing Project at Samsung Abu Dhabi Oil and Gas Plant

    Project Overview In February 2024, ADNOC approved a critical retubing project at the Samsung Abu Dhabi Oil and Gas Refinery Plant. The primary objective was to address significant operational issues, including pressure drops and leaks in the heat exchangers, which compromised the plant’s efficiency and safety. The project commenced on February 26, 2024, with an […]
    March 24, 2025
    Omkar Avatar

Leave a Reply

Your email address will not be published. Required fields are marked *
